Mission Training Center Updates

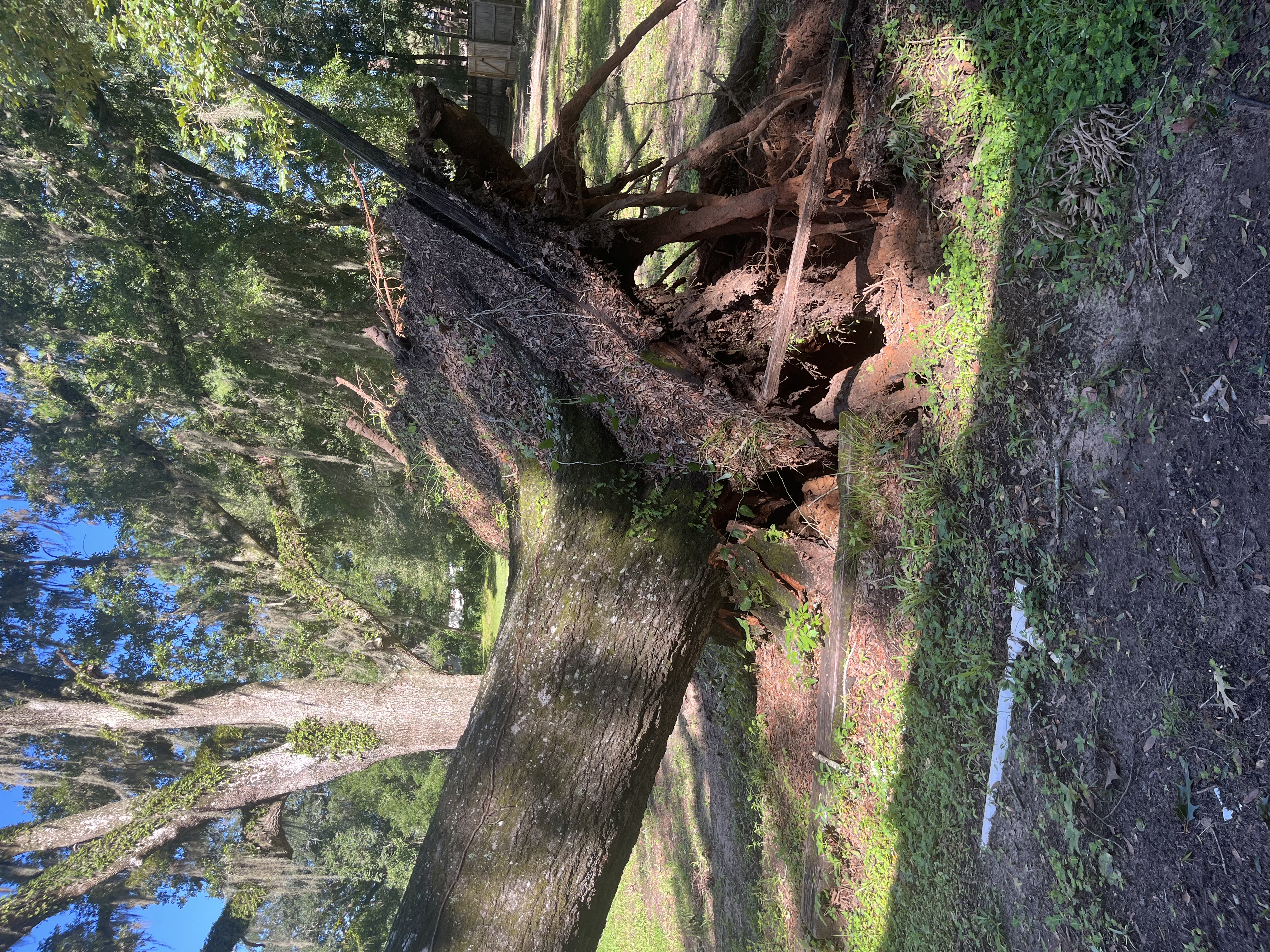

In August 2024, a tree fell on the Mission Training Center during Hurricane Debby.

Learn about plans for this ministry space and get updates on progress below.

February 2026 Update

As of February 3, 2026 we are waiting on permits. We should have the construction permit from the City of Tallahassee within the next 10 days.

Seven trees on the property must be removed to complete the renovation and ensure safety. We have received permits from the City to remove four of the trees, but the other three fall within the Centerville canopy zone. A special permit from the Canopy Roads Committee is required for their removal. We are currently waiting for the next committee meeting to obtain the permit. Replanting trees on the property and along the canopy is already part of the project to preserve the unique beauty of Centerville Road.

We plan to begin construction around March 10. If we are still waiting for the permit from the Canopy Roads Committee, we will work around those trees for now. Construction should take 5-6 months, and our goal is to open the space at the beginning of August!

January 2026 Update

Thank you to everyone who attended our Special Business Meeting on January 14. The church family voted almost unanimously (only one "No" vote, all others in favor) to pursue the funding needed to complete the proposed renovations of the Mission Training Center.

Updates from Pastor David

October 2025 Update. See below for drawings, cost breakdowns, and more.

May 2025 Update on the Mission Training Center from Pastor David

Cost Breakdown

Construction & Labor Costs- $306,108
Demolition- $49,950
Structural Repairs- $279,600
Exterior- $301,555
Interior- $483,771

Financial Information

Funds Available: $617,744.77 (from insurance payout and sale of property to Blueprint Intergovernmental Agency)

Guaranteed Maximum Price from Contractor: $1,420,984.00

Difference: $803,239.23

Timeline

More details will be added to the timeline as they become available from our contractor.

November 2025

Repairs and renovations begin using funds on hand. The initial focus will be on drying-in the building and repairing the roof to prevent any further damage.

January 14, 2026

Special Called Business Meeting
6pm in the Gym

The church membership will vote on financing options for completing the construction work.

May 2026

Estimated completion of all work and opening of the newly renovated Mission Training Center.
